A realistic month-by-month timeline for a G+1 house in India, from design and building permission to handover, with the curing, inspection and monsoon limits that decide how fast each stage can go.
A G+1 independent house in India usually takes 14 to 18 months from your first meeting with an architect to moving in: roughly 4 to 6 months of design and approvals, then 10 to 12 months on site. The parts you cannot rush are set by rules, not by the contractor: how long concrete must stay propped and wet under IS 456, and how long the authority has to inspect your plinth and completed house.
About the numbers below: the month ranges are our guidance for an RCC-framed G+1 house of about 2,000 to 2,500 sq ft, not survey data; no official source publishes a standard duration. The minimums are sourced: curing and formwork times from BIS codes, inspection windows from the national Model Building Bye-Laws 2016 (your state's rules may differ), and power connection times from the Ministry of Power.
| Stage | Our estimate | What sets the minimum | What usually delays it |
|---|---|---|---|
| Brief, concept and design | 2 to 3 months | Your decisions | Changing the brief, slow sign-offs |
| Building permission | 1 to 3 months | Authority scrutiny | Queries, title or land-use issues |
| Working drawings, contractor | 1 to 2 months (overlaps the permit) | Drawing and tender work | Vague drawings, re-quoting |
| Excavation to plinth | 1.5 to 2 months | Curing, plinth inspection | Rain, rock, a high water table |
| RCC frame, two slabs | 2.5 to 3.5 months | IS 456 props and curing | Monsoon, concrete and steel supply |
| Masonry, wiring, plumbing | 2 to 3 months | IS 2212 curing | Labour, late layout decisions |
| Plaster, waterproofing, floors | 2.5 to 3.5 months | IS 1661 curing | Monsoon for outside work, tile delivery |
| Doors, windows, paint, fixtures | 1.5 to 2 months | Supplier lead times | Ordering late |
| Completion and handover | About 1 month | Authority inspection, utility rules | Deviations from the sanctioned plan |

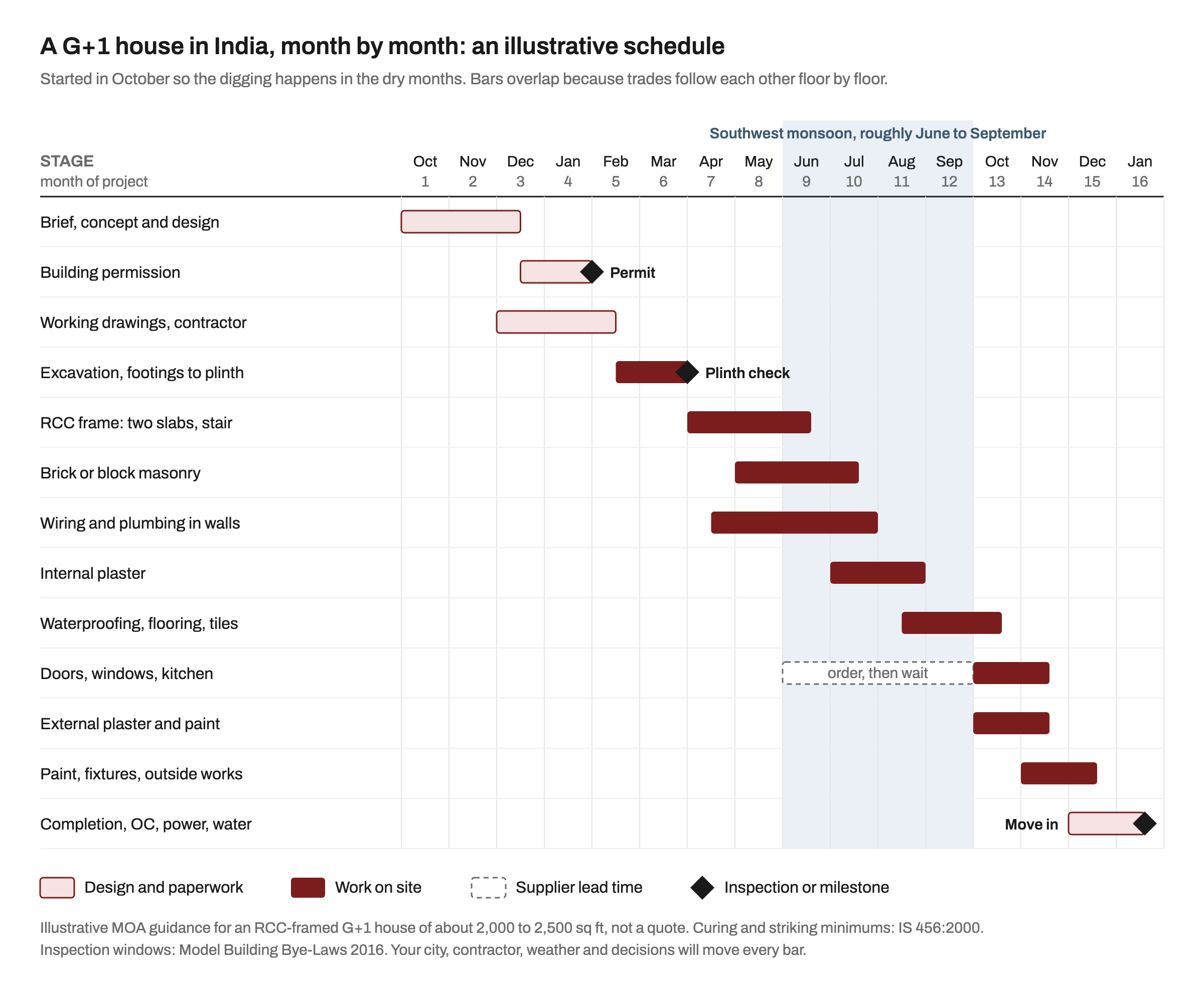

The stages overlap, so the total is shorter than the sum. Here they are on a calendar, starting design in October.
Why October? The southwest monsoon normally reaches Kerala by 1 June and covers the whole country by 8 July, then starts withdrawing from northwest India around 17 September and is gone by 15 October, according to the IMD dates reported by PTI. Starting design after the rains puts digging in the dry months and the roof on before the heavy rain.
The Council of Architecture's Conditions of Engagement split this into concept design, a preliminary scheme with a cost estimate, and then drawings submitted for approval. On a house, the time goes on decisions: bedrooms, the stair, Vastu revisions. Every revision after the preliminary scheme costs weeks.
Start the structural engineer now too. Under the national Model Building Bye-Laws 2016 (clause 6.1.2), the first part of the Structural Design Basis Report goes in with the drawings for approval, and for a reinforced concrete building the completed concrete part must be submitted before construction begins.
What helps: fix your budget first, with our 2026 cost breakdown or the MOA home cost calculator, so the design is not redrawn to cut cost later. Clear the plot's title and land use too, using our plot due diligence checklist.
On paper this is quick. The Model Building Bye-Laws class a residential plot of 105 to 500 sq m with a building below 15 m as low risk, and suggest a permit within 10 days of a complete application (chapter 13). Under clause 2.14.2, if the authority does not respond within 15 days the plan can be deemed sanctioned, but only on plots in an approved layout. Once granted, a permit stays valid for three years from the date of sanction (clause 2.14.3).
In practice, plan for one to three months. These are model bye-laws: states and cities adopt their own versions, and the real wait is the scrutiny of your file and any queries. In Pune, for example, three different authorities issue permits, and since Maharashtra's 2025 reform the building permission also converts agricultural land where housing is allowed. Our guide to building permission in Pune walks through that sequence.
Use the wait. Your architect can finish working drawings and quantities, and you can compare contractors on the same drawings. Our guide to turnkey, item-rate and labour-rate contracts explains which suits you. Ask every bidder for a written time schedule: under clause 9.04 of the COA conditions, your architect advises you on it.
Setting out, excavation, footings, columns up to plinth, the plinth beam and backfilling. Rock, soft soil or groundwater slow it down.
Then comes the inspection people forget to plan for. Clause 2.15.3 of the Model Bye-Laws asks you to notify the authority at plinth level; it has 15 days to inspect and object, after which the work is deemed cleared. Building higher before that is how a small setback error becomes a demolition order instead of a redraw.
This is also the stage you least want in the rain, because open pits flood and their sides collapse. If your permit lands in May, our guidance is to finish the drawings and dig after the monsoon; your engineer will know your soil.

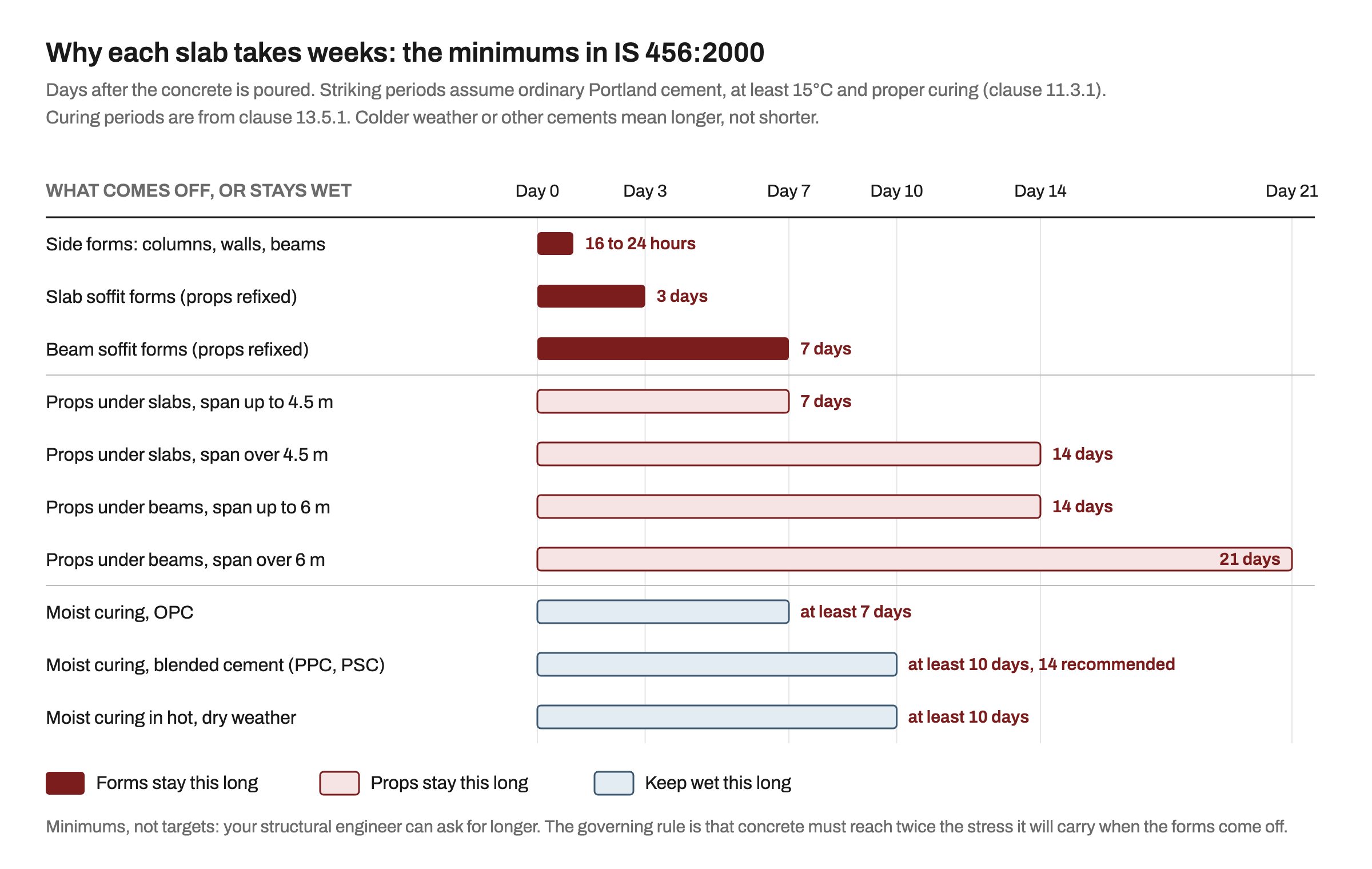

Here the codes set the pace. Clause 11.3.1 of IS 456:2000, the Indian standard for reinforced concrete, gives minimum periods before formwork and props come off, for ordinary Portland cement at an ambient temperature of at least 15°C with proper curing. Clause 13.5.1 sets the curing periods.
The underlying rule is strength: forms come off only once concrete reaches twice the stress it will then carry. Colder weather and other cements may need longer, which matters in a north Indian winter.
Add column work, shuttering, steel, conduits and the engineer's check before each pour, and our estimate is three to five weeks per floor. With two roof slabs plus the stair headroom, the frame takes about two and a half to three and a half months. The classic shortcut is stripping props early to reuse shuttering upstairs. Your structural engineer can ask for longer than the code minimums, never shorter.
Ground floor walls start while the first floor frame is still going up. IS 2212:1991, the brickwork code, asks for brickwork to be kept wet for at least seven days in hot and dry weather (clause 11.10). Conduits, switch boxes and plumbing lines go into the walls before plaster, so the furniture and kitchen layout must be final by now.
Now order anything made to measure. Fabricated windows, doors and modular kitchens are built to the measured openings, so they arrive weeks after ordering. Get each supplier's lead time in writing; it is the dashed bar in the schedule above.
IS 1661:1972, the plaster code, keeps each coat damp until the next goes on (up to 7 days) and the finished plaster wet for at least seven days (clause 16). Internal plaster can run through the monsoon under the roof; in our view, external plaster and paint should wait for the rains to end.
Then terrace and bathroom waterproofing, flooring and wall tiles. Have the waterproofing tested with water before tiles cover it, and choose tiles early so a short delivery does not hold up a floor.
Doors and windows, paint, fittings, the compound wall and paving. Then the paperwork that makes the house legal to live in:
Make a written snag list with your architect before the final payment, and collect the as-built drawings.
Our ranking from the stages above (guidance, not a survey):
The fix for most of these: a complete drawing set before you start, a contract with a schedule and payments tied to finished stages, and someone on site who works for you.
Our estimate is 10 to 12 months on site for an RCC-framed G+1 house of about 2,000 to 2,500 sq ft, and 14 to 18 months including design and approvals. Difficult soil, a slow authority or a monsoon start push it longer.
A G+1 house in six months from a standing start is unrealistic: two slabs need weeks of propping and curing under IS 456, and the plinth and completion inspections each allow the authority 15 days under the model bye-laws.
Under IS 456:2000, slab soffit forms can come off after 3 days if props are refixed at once, and props under a slab spanning up to 4.5 m stay 7 days (14 above). Curing continues for at least 7 days with ordinary Portland cement, 10 with blended cement. These assume at least 15°C.
Starting excavation in the monsoon is risky, because pits flood. If you can, finish the foundation before June and cast the roof early in the rains.
Find an architect on MOA who handles approvals and site supervision, and ask for a written schedule.
