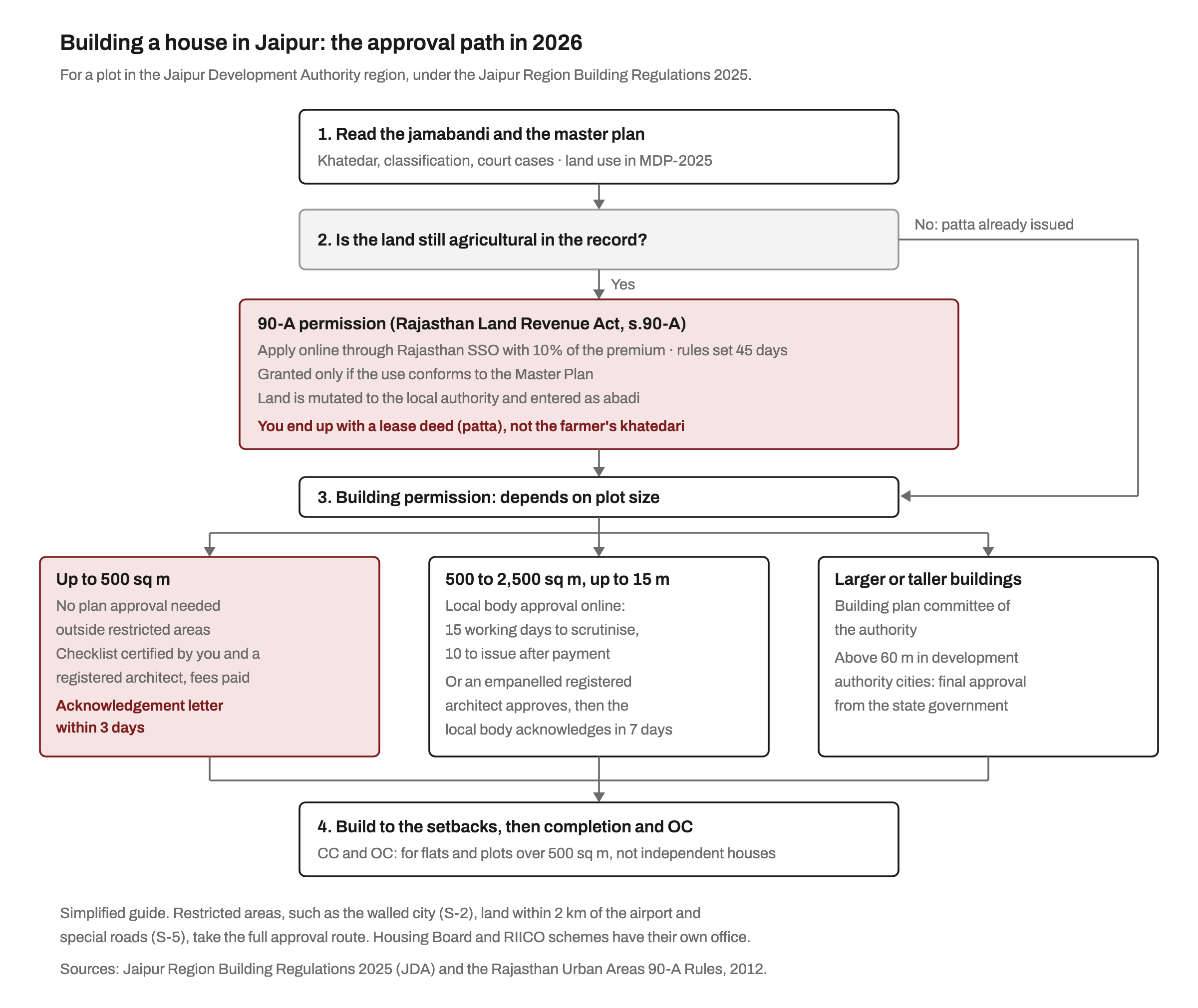

How 90-A conversion turns farm land into a JDA patta, who approves buildings now that Jaipur has one corporation again, and the 2025 rules that drop plan approval for most plots up to 500 sq m.
Before you rely on any of this: Jaipur's building rules changed on 25 August 2025, when the Jaipur Region Building Regulations 2025 came into force, and the city returned to a single municipal corporation in November 2025. This guide was updated in October 2026. Confirm the current position on the official portal, or with an architect who has filed in your area recently, before you spend money. This is a plain-English guide, not legal advice.
Building a house in Jaipur takes two separate approvals, in order. If the land is still agricultural in the revenue record, it first needs permission under section 90-A of the Rajasthan Land Revenue Act, 1956, which turns it into a leased urban plot. Only then does building permission come in. Since August 2025, for most plots up to 500 sq m, that permission is a certified checklist and a fee rather than a plan approval.
Sellers often say "it is 90-A land" to reassure you. That phrase is not a document. What you want is the 90-A permission for that specific khasra and, after it, a lease deed (patta) in your seller's name.
As a rule of thumb (guidance, not a rule), start with the office that issued your plot's patta; a JDA zone office can tell you whether the plot is in a JDA scheme.
For what these rules mean on a plot, see our explainer on setbacks, FAR and height limits.
Rule 3 bars permission on, among others, gair khatedari and forest land and land within 200 m of historical monuments. Our plot due diligence checklist covers the other checks to run before you pay.
Section 90-A allows agricultural land to be used for a non-agricultural purpose, and in Jaipur it does more than change a label. Once the Authorised Officer grants permission, rule 7 has the Tehsildar mutate the land in favour of the local authority, as abadi land since the 2022 amendment. The farmer's khatedari ends, the local authority approves the layout, and the plot is allotted on a lease or freehold deed. That is why a converted plot comes with a JDA patta, not a khatedari entry.
The Tehsildar and the local authority have 15 days to respond, and the Tehsildar's silence counts as consent. A seven-day public notice in a state-level newspaper, at your cost, invites objections. The Authorised Officer is to decide within 45 days or record reasons for the delay. The premium is due within 90 days of the demand, with 15 per cent interest after that, and the permission is deemed cancelled if it is unpaid after six months.
JDA publishes its land conversion minutes. Unlike Maharashtra, which folded conversion into the building permission in 2025, we found no 2025 or 2026 change to section 90-A; the latest we could confirm is the 2022 regularisation change below.
Many Jaipur colonies were laid out on farm land by housing cooperative societies, with society pattas instead of JDA leases. Under section 90-A(8), where such land was used or sold for non-agricultural use before a cut-off date, it passes to the local authority, which can regularise plots for the people in possession on a society patta, sale agreement, power of attorney or will.
If a plot carries only a society patta, ask whether the colony is regularised and a JDA lease deed issued.
Regulation 13 sorts plots by size. These routes apply outside restricted areas: the walled city (S-2), land within 2 km of the airport or in its red zone, land near army areas, and special areas and roads (S-5), where full approval applies at any size.
| Plot | Route | What the regulations promise |
|---|---|---|
| Up to 500 sq m, or up to 500 sq m built-up | No plan approval needed (regulation 13.4). You and a registered architect certify the Schedule 5 checklist and you pay the fees. | Acknowledgement letter from the local body within 3 days |
| Up to 500 sq m, with a new lease deed | Approval for ground plus first floor, up to 8 m, is issued with the patta (regulation 13.3) | Taller plans follow the normal route, with the fee already paid adjusted |
| 500 to 2,500 sq m, up to 15 m | Online application to the local body (13.5), or approval by a state-empanelled registered architect (13.6), except in Housing Board and RIICO areas | Local body: 15 working days to scrutinise, approval within 10 working days of payment. Architect route: acknowledgement within 7 days, and work starts only after it. |
| Larger or taller | Building plan committee of the authority | Above 60 m in development authority cities, final approval from the state government |
Three details matter. "No approval needed" still means setbacks and every other norm apply, and anything built against them is unauthorised. If the local body sits on a complete, paid application beyond 10 working days, regulation 13.5 says compliant construction is not unauthorised. And plans filed with the local body must be drawn and signed by an architect registered with the Council of Architecture (or an associate of the Indian Institute of Architects).
On JDA's Building Plan Approval service (as described in October 2026) you sign in through Rajasthan SSO, pay a ₹500 registration valid for five years, apply online, then submit a hard copy at the Citizen Care Centre. Your architect signs and usually files, so appoint one early: browse architects and interior designers in Jaipur on MOA.
Plinth inspection. The regulations class buildings as low risk (up to 500 sq m and 15 m), medium (500 to 2,500 sq m, up to 15 m) or high (above 15 m), and let a registered architect do the plinth inspection for medium and high risk. On any plot, checking setbacks at plinth level is cheaper than correcting them later.
Completion and Occupancy Certificates. Under regulation 15.1 they are compulsory for flats, group housing and plots above 500 sq m, but not for independent houses. JDA offers both online. Keep the acknowledgement letter or approved drawings with your papers, because banks and buyers ask.
For a realistic budget once approvals are in hand, see our Jaipur construction cost breakdown.
Agricultural land permitted for non-agricultural use under section 90-A of the Rajasthan Land Revenue Act, 1956. In urban areas it then passes to the local authority, which issues a lease deed (patta).
No. Ask for the 90-A permission for that khasra and the lease deed issued after it, and check the jamabandi yourself.
Not a plan approval, if the plot is up to 500 sq m and outside restricted areas. You file a checklist certified with a registered architect, pay the fees and get an acknowledgement within 3 days. The setbacks still apply.
No. They merged into a single Jaipur Municipal Corporation on 10 November 2025.
Yes. JDA extended it to 5 September 2027 or until a new plan is notified, whichever is earlier.
See architects practising in Jaipur on MOA, look at their published work and message them directly.
