The seven stages of an Indian architect's fee proposal, what each should deliver, how the fee is split, what sits outside it, and whether the COA scale of charges is mandatory.
A good architect's fee proposal tells you three things clearly: what you will receive at each stage, how much you pay at the end of each stage, and what is not included. In India, the reference for all three is the Council of Architecture's Conditions of Engagement and Scale of Charges, which splits a project into seven stages from concept design to completion. This guide walks through a typical proposal line by line, explains where the COA scale stands legally today, and lists the red flags worth questioning before you sign.
About the numbers below: the stages, percentages and clauses come from the Council of Architecture's published Conditions of Engagement and Scale of Charges (the 2002 revision, still current on coa.gov.in on 16 Oct 2026). The ₹80 lakh house in the worked example is illustrative, not a market rate. The fee you are quoted may differ. This is general information, not legal advice.
If you are still comparing how architects charge (percentage, per square foot or lump sum), start with our guide to architect and interior designer fees in India. This post picks up once a proposal is in your hands.
The honest answer has two halves.
The Architects (Professional Conduct) Regulations, 1989 were made by the Council of Architecture, with the approval of the Central Government, under Section 45 of the Architects Act, 1972. Two duties in Regulation 2(1) are about fees:
Regulation 2(3) says a violation of these duties is professional misconduct. The regulations were amended in 2003, and the version the COA publishes today still contains both clauses.
The COA's own preamble to the document calls it a "mandatory minimum scale of professional charges". It was approved at the Council's 40th meeting in April 2002, and the scale itself is headed "Minimum fees". For an individual house, that minimum is 7.5% of the cost of works. The scale also says fees may be negotiated between architect and client on works costing up to ₹14 lakh.
The government's own works department reads it differently. A 2015 Central Public Works Department office memorandum (Circular DG/P&WA/79, reproduced by the Architexturez archive) states that the COA's conditions and scale are "neither approved by the Parliament under the Architects Act, 1972 nor by the Central Government". It told CPWD officers not to use them to award work or justify a quote. The COA disagrees: in a 2019 letter to the Housing Ministry about the Central Vista consultancy, it asked that fees be fixed as the Council prescribes, not by architects quoting the lowest fee.
We also checked the Competition Commission of India and found no published order naming the Council of Architecture or its scale of charges in the CCI's list of antitrust orders from 2010 to September 2026. A few listed orders are anonymised, so a confidential matter cannot be ruled out.
Our reading, for a homeowner: the duty to uphold the scale sits on the architect, under the COA's professional conduct rules. It is not a price a private client is legally bound to pay; your written agreement fixes your fee. Treat the scale as the best published reference for what a full service includes, how payments are staged and which extras are fair. If a quote is far below it, ask what has been left out of the scope.

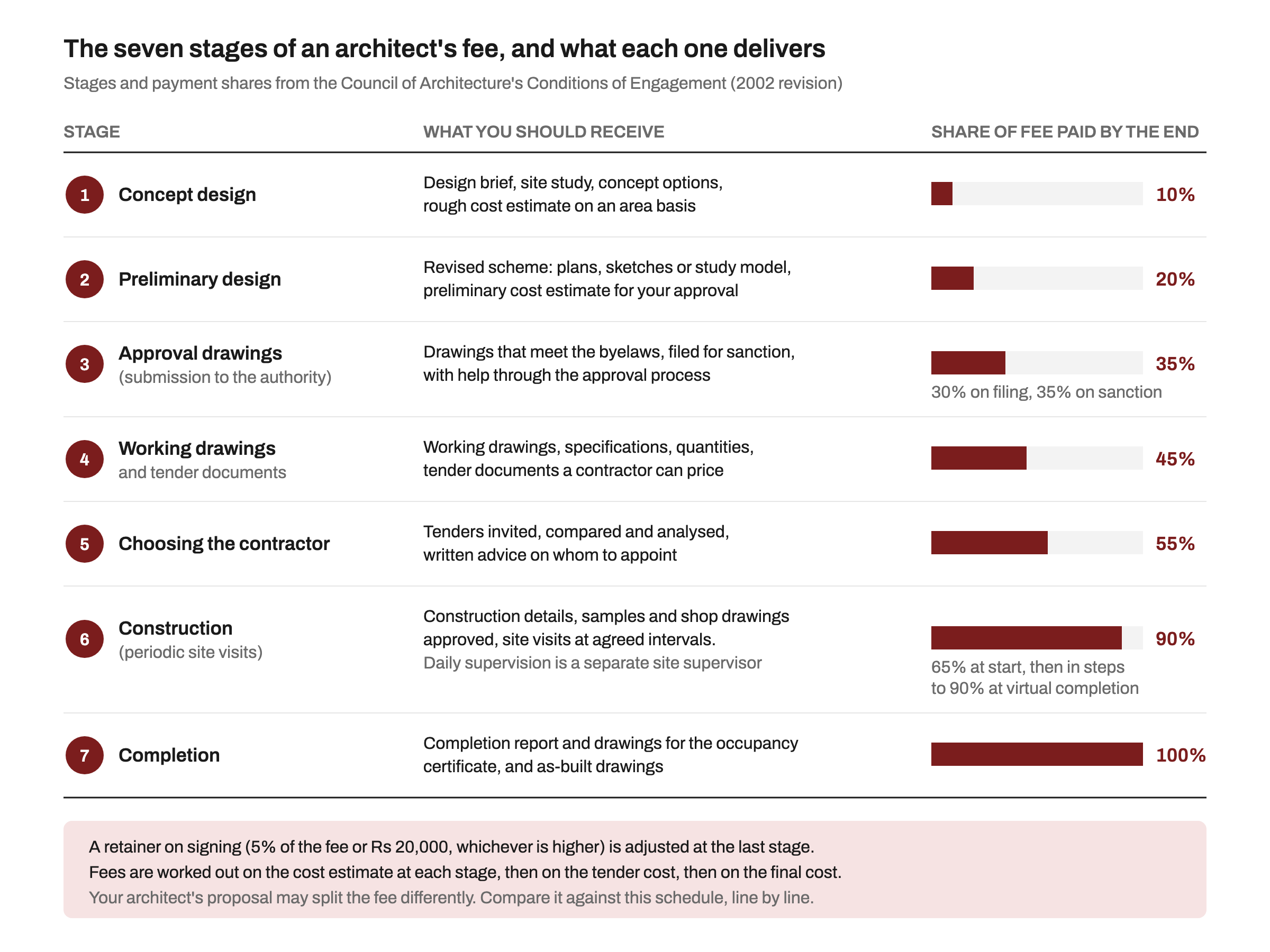

Proposals often rename or merge these stages. The test is simple: at the end of each stage, you should hold something specific before you pay for it.
The COA schedule is cumulative: each figure is the share of the total fee paid by the end of that stage, less what was paid before.
| Stage | Paid by the end of the stage | Illustrative: fee of ₹6 lakh |
|---|---|---|
| Retainer, on signing | 5% of fee or ₹20,000, whichever is higher (adjusted at the end) | ₹30,000 |
| 1. Concept design | 10% | ₹60,000 |
| 2. Preliminary design | 20% | ₹1,20,000 |
| 3. Approval drawings | 30% on filing, 35% on sanction | ₹2,10,000 |
| 4. Working drawings and tender | 45% | ₹2,70,000 |
| 5. Choosing the contractor | 55% | ₹3,30,000 |
| 6. Construction | 65% at start, then 70, 75, 80 and 85% at each 20% of work, 90% at virtual completion | ₹5,40,000 |
| 7. Completion | 100% | ₹6,00,000 |
The illustration assumes an individual house costing ₹80 lakh to build, at the COA minimum of 7.5%. Two details matter:
The MOA home cost calculator gives you a construction estimate to test a percentage quote against.

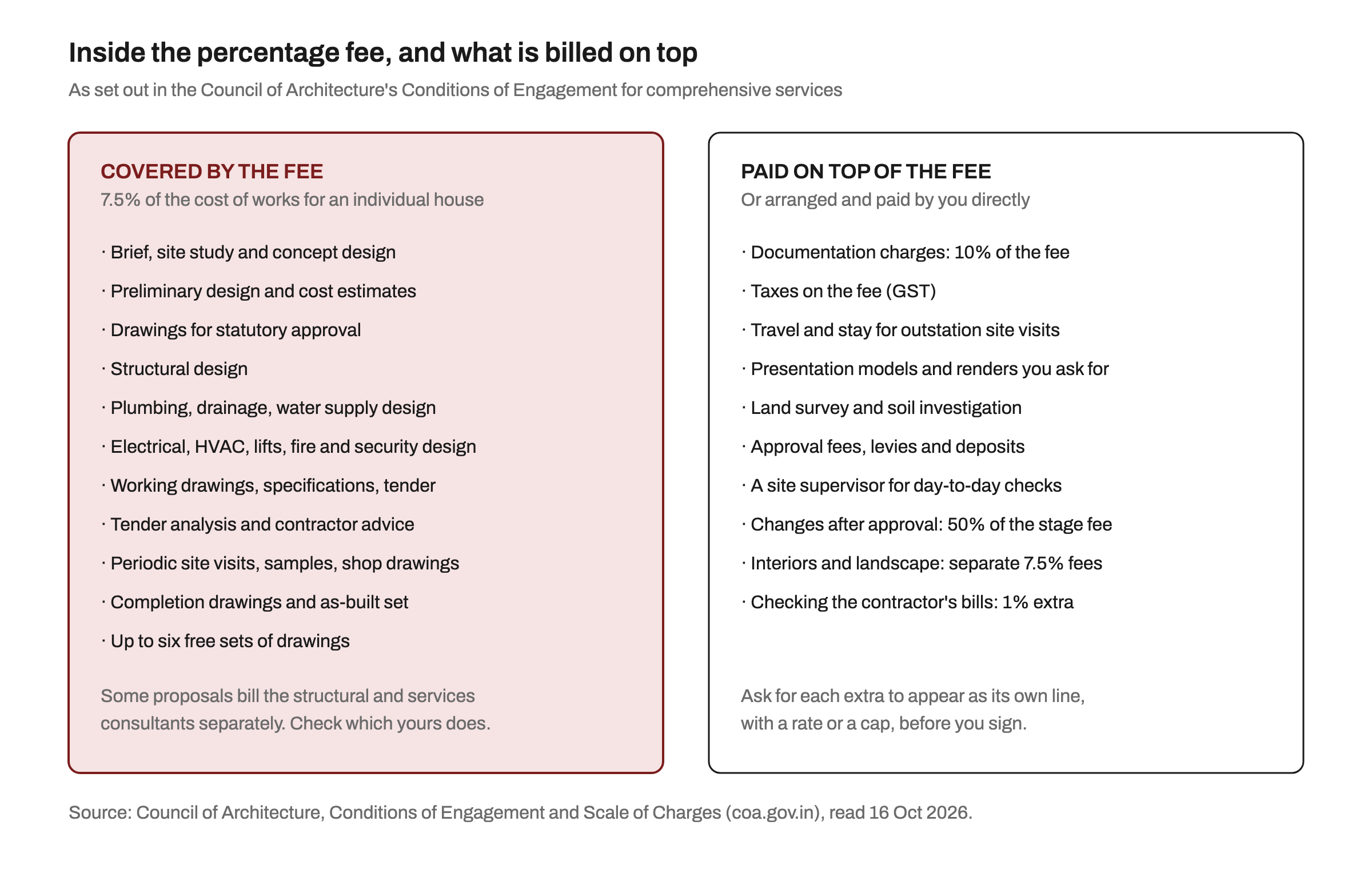

Under the COA's conditions for comprehensive services, the fee covers architecture plus the structural, plumbing, electrical, HVAC, lift and fire design, with the architect directing any specialist consultants. Some proposals instead bill structural and services consultants separately, so check which model you have been given.
The COA conditions put these on top of the fee, or on you directly:
Our guidance, based on the COA documents above. None of these means the architect is dishonest, but each deserves a written answer.
Our post on 10 clauses to read in your architect's contract covers ownership of drawings, termination and disputes in more depth, and these 15 questions to ask before hiring help you compare two or three proposals fairly.
The 1989 regulations bar architects from preparing designs in competition for a client without payment, except in a COA-guided competition. You may consult as many architects as you like while selecting one, provided you pay each. So compare past work and interviews, or pay for the sketches.
The COA scale sets a minimum of 7.5% of the cost of works for an individual house, for comprehensive services. Documentation charges of 10% of the fee, reimbursables and GST are extra. On works up to ₹14 lakh, the scale allows the fee to be negotiated.
Under the COA's professional conduct rules, architects are expected to uphold the scale, and the COA calls it a mandatory minimum. The rules bind the architect, not you, and your written agreement fixes your fee. If a quote is much lower, check that the scope is the same.
The COA schedule has a retainer on signing of 5% of the total fee or ₹20,000, whichever is higher, adjusted against the last stage. After that, payments follow completed stages.
Under the COA's comprehensive services, yes: structural, plumbing, electrical, HVAC and fire design are part of the scope. Some proposals bill consultants separately, so read the exclusions and ask.
Yes. Under the COA conditions, taxes on the architect's services are payable by the client on top of the fee. Ask for GST as its own line on each invoice.
Ready to compare proposals? Find architects on MOA and look at their built work first.
