OPC, PPC or PSC for your house? What IS 269, IS 1489 and IS 455 actually guarantee, which cement suits footings, slabs, masonry and plaster, curing times, and how to check any bag.
For most of an Indian house, a BIS-certified PPC (Portland pozzolana cement) or PSC (Portland slag cement) is a sound choice: footings, slabs, masonry and plaster. OPC 43 or 53 earns its place where early strength matters, and the structural engineer's mix design, not the grade printed on the bag, decides how strong your concrete is. Whichever you buy, check the ISI mark, the CM/L licence number and the week of packing before the bags are unloaded.
About the numbers below: strength, composition and curing figures are taken from the BIS standards and codes linked in each section, as BIS summarises them in its 2025 cement compendium. Which cement to use where is our guidance, built on those codes, and your structural engineer's drawings override it. Prices are indicative schedule rates from one state PWD schedule, not dealer quotes.
All three start with the same Portland cement clinker. The difference is what is ground or blended in with it, and BIS sets the limits in a separate standard for each. The current editions, as listed in the BIS Compendium of Indian Standards on Cement (2025), are:
IS 456:2000, the concrete code, still cites IS 8112 and IS 12269; read them as OPC 43 and 53 under IS 269:2015.
The grade is the minimum compressive strength, in MPa, of standard 1:3 cement and sand mortar cubes at 28 days. It is not the strength of your concrete. These minimums are from the BIS compendium:
| Cement | 3 days | 7 days | 28 days |
|---|---|---|---|
| OPC 33 | 16 | 22 | 33 (max 48) |
| OPC 43 | 23 | 33 | 43 (max 58) |
| OPC 53 | 27 | 37 | 53 |
| PPC (Part 1 or 2) | 16 | 22 | 33 |
| PSC | 16 | 22 | 33 |
OPC 53 is guaranteed more early strength, which helps when formwork must come off quickly. PPC and PSC share OPC 33's floor, and every standard requires strength to keep rising after 3 days. These are minimums only.
IS 456:2000 sets minimum cement content and maximum water to cement ratio for concrete "irrespective of the grades of cement" (Table 5). M20 or M25 concrete comes from the mix, the water and the curing, not from switching 43 for 53.
BIS describes PPC as usable wherever OPC is, except where high early strength is a special requirement. For a house, OPC is useful mainly when a tight schedule needs early form removal. Otherwise blended cements do the job, and cost less in the Telangana schedule below.
Cement gives off heat as it sets. BIS lists PPC for mass concrete such as dams and foundations, and notes that composite cement (fly ash plus slag, IS 16415) cuts thermal cracking through its lower heat of hydration. In a house, our guidance is that this matters most in thick rafts and in hot-weather concreting.
Durability is where PPC and PSC have a real edge. BIS says PSC offers high resistance to chloride and sulphate attack and lists it for marine work, piling and basements. IS 456 ties the concrete you need to the exposure:
Only a soil and water test tells you the class, so get one before the foundation is designed.

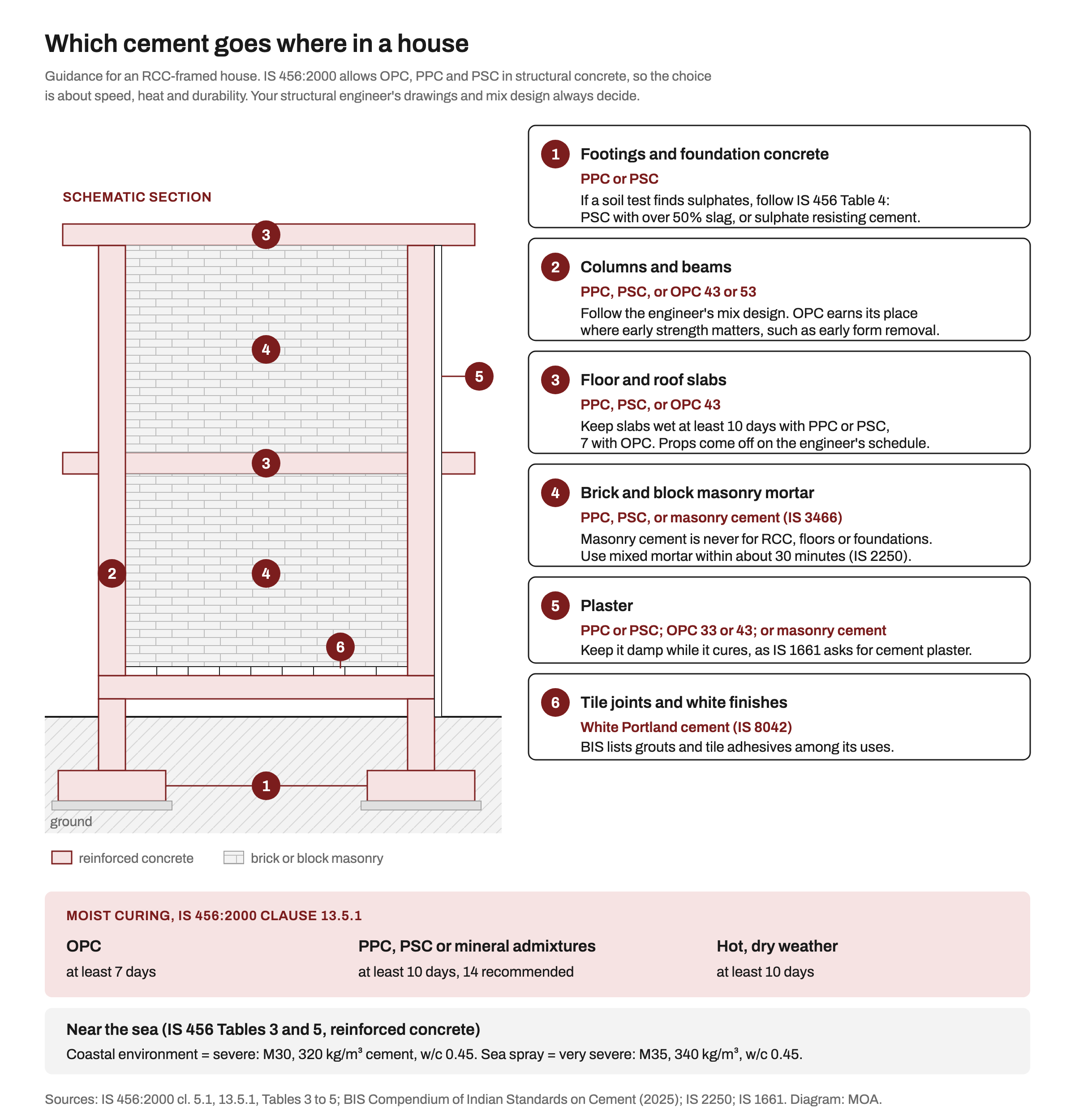

IS 456 clause 5.1 allows OPC, PPC and PSC in structural concrete, so this is a choice, not a rule. Our guidance, element by element:
Clause 13.5.1 of IS 456 says concrete must be kept continuously wet for at least 7 days with OPC and at least 10 days where blended cements or mineral admixtures are used, extendable to 14. In hot, dry weather the minimum is 10 days whatever the cement. Curing PPC or PSC on an OPC schedule falls short of the code. For when props and shuttering can come off, see our stage-by-stage construction timeline.
Mortar has its own clock: IS 2250 says mix only what can be used in about 30 minutes.

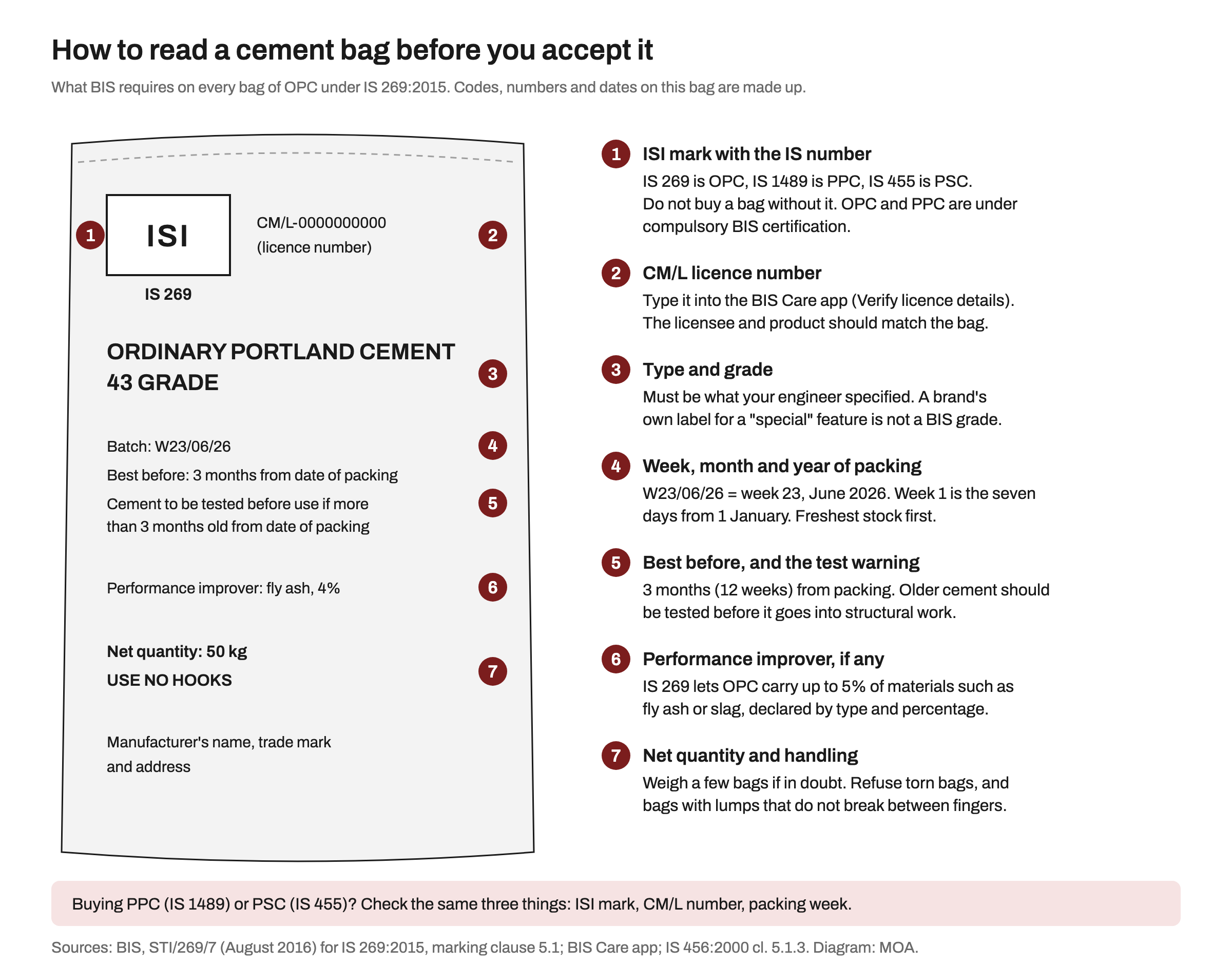

We do not rank brands. IS 456 clause 5.1.3 says "special" features claimed on bags alongside the quality mark have no relation whatsoever to what the mark guarantees. Judge the bag, not the advertising.
That marking list is from BIS's 2016 scheme for IS 269. For PPC and PSC, look for the same mark, licence number and packing week.
IS 4082:1996 asks for a dry shed, bags on planks 150 to 200 mm off the floor and 600 mm clear of outside walls, stacks no more than 10 bags high, each dated and used first in, first out, polythene cover in the monsoon, and each cement type stacked separately.
Indicative rates, not market prices: the Government of Telangana Common Schedule of Rates 2026-27 (effective 1 June 2026) lists cement delivered at site, excluding GST, as:
The schedule notes these are revised monthly by a sub-committee. Rates in your state will differ: check your state PWD Schedule of Rates for the current year, and expect dealer prices to vary by town, brand and season.
Cement is one line in a house budget: see our state-wise cost breakdown, the Hyderabad cost guide, or MOA's home cost calculator. If the contractor supplies materials, write the cement type, grade and IS number into the contract (see turnkey, item-rate or labour-rate).
PPC, PSC or OPC 43 all work. The engineer's mix, compaction and curing matter more: at least 7 days for OPC and 10 for PPC or PSC under IS 456. Choose OPC if shuttering must come off early.
Neither is better everywhere. OPC gains strength faster. PPC costs a little less in the Telangana schedule, and BIS lists it for marine and mass concrete as well as general building. For most homes, our guidance is PPC for general work and OPC where early strength is needed.
Not automatically. The grade is the cement's 28-day mortar strength, and IS 456 sets cement content irrespective of grade. 53 helps early strength; in our view, 43 is usually enough for a house.
OPC bags carry a best-before date 3 months from packing, and cement older than that should be tested before use. Read the week code, not the invoice date.
IS 1661, the plastering code, names OPC and PSC, and BIS also lists masonry cement for rendering and plastering. PPC, which BIS calls the most widely used cement in building construction, is a common choice too. Whichever you use, keep the plaster damp while it cures, as IS 1661 asks.
