Who approves your building in Coimbatore: self-certification, the Corporation or DTCP. Plus Master Plan 2041 zoning, change of land use and the completion certificate, with official links.
Before you rely on any of this: Coimbatore got a new master plan in July 2025, Tamil Nadu has amended its building rules many times since 2019, and more changes were announced in August 2026. This guide was updated in October 2026 and links to its sources. Confirm the current position on the official portal, or with an architect who has filed in your area recently, before you spend money. This is a plain-English guide, not legal advice.

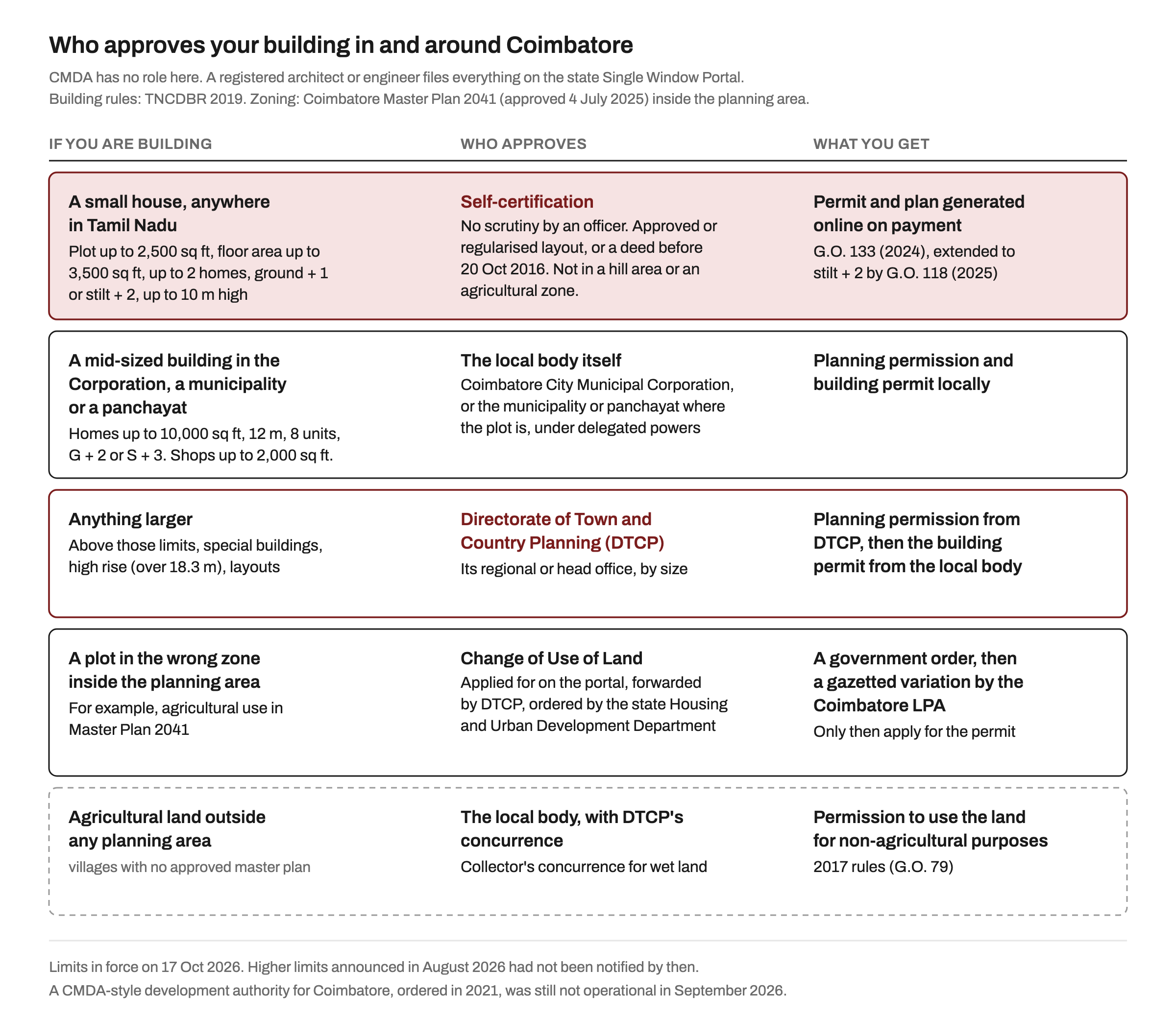

In Coimbatore, a small house can get its permit instantly by self-certification, a mid-sized home is approved by the local body (the City Municipal Corporation, a municipality or a panchayat), and anything larger goes to the Directorate of Town and Country Planning (DTCP). There is no CMDA here: the zoning comes from the Coimbatore Local Planning Authority's Master Plan 2041, approved by the state on 4 July 2025.
The land comes first, though. Check the zone your survey number falls in under the new plan, and whether the plot sits in an approved layout. Get those right and the permit is mostly paperwork.
Unlike Chennai, which has CMDA (see our Chennai guide), Coimbatore has three bodies to know:
What about a "Coimbatore development authority"? The state ordered CMDA-style urban development authorities for Coimbatore, Madurai, Tiruppur and Hosur in 2021, according to DT Next. Construction World reported on 1 September 2026 that they had never become operational and would start in phases. Until one is working, file with the bodies above.
To find your local body, use the portal's Know Your Local Body search.
For what setbacks, FSI and height limits mean on your plot, see our explainer on setbacks, FAR and height limits.
Pull the patta, chitta and FMB (field measurement book) sketch from the Revenue Department's e-Services of Land Records portal (the Town Survey Land Register in city areas), and check the owner and extent against the sale deed.
Then check the zone under Master Plan 2041, not the 1994 plan or what the neighbours built. G.O. 103 directs that the approved plan and all its enclosures be kept open for public inspection on working days at the office of the Coimbatore Municipal Corporation. Ask your architect to confirm the zone for your survey number there or at the LPA.
Also look for later changes. The LPA publishes each one as a "Variation to the Approved Coimbatore Master Plan" in the Gazette, by survey number. Two this year:
Our plot due diligence checklist covers the other checks to run before you pay.
If your survey number is zoned for something else, such as agriculture, the zone has to change before a permit can be issued. The single window portal's DTCP change of land use page lists what to file:
The decision is the government's: in both 2026 variations above, a Housing and Urban Development Department order approved the change with conditions, and the LPA then gazetted it. G.O. Ms. No. 161 renamed the old "reclassification" as "Change of Use of Land" and cut the documents needed. In the July 2026 example, the order came in March and the variation was gazetted in July, so budget months, and never buy assuming the change will be granted.
Villages with no approved master plan follow the Change of Land Use (Agriculture to Non-agriculture in Non-planning Areas) Rules, 2017. You apply to the local body in Form I with a scrutiny fee of ₹1,000 a plot. The local body needs DTCP's concurrence, and DTCP needs the Collector's concurrence for wet land or a report from the Joint Director of Agriculture for dry land. The Collector must be satisfied that the land is not a water body, poramboke or temple land, or still fit for cultivation.
Plots in layouts registered on or before 20 October 2016 can be regularised across Tamil Nadu. G.O. (Ms) No. 148 of 27 July 2026, published on the regularisation portal, extended the time to apply to 30 June 2027 with no change to the conditions. Our Chennai guide explains how the two stages work.
All applications go through the Tamil Nadu Single Window Portal for Planning Permission, which publishes a document checklist. Only registered professionals can file, so appoint yours early. Our guide to the drawing set your architect should hand over lists what the file is built from.
Self-certification applies across Tamil Nadu, including Coimbatore. Under G.O. Ms. No. 133 (18 July 2024), as extended by G.O. Ms. No. 118 (8 August 2025):
The hill area exclusion matters here: parts of Coimbatore district are in the notified hill area, and the portal's power delegation table sends those files down a separate route. Construction World reported in September 2026 that a committee is surveying the district to identify areas that could leave the Hill Area Planning region. Until that is notified, check your village.
Everything else is scrutinised. The power delegation table and the portal's application workflow set the split:
| Building | Who issues planning permission |
|---|---|
| Homes up to 10,000 sq ft, 12 m, eight dwelling units, ground plus two or stilt plus three | The local body: the Corporation, a municipality or a panchayat |
| Shops up to 2,000 sq ft, ground plus one or stilt plus two | The local body |
| Anything above these limits, high rise over 18.3 m, and layouts | DTCP, through its regional or head office depending on size |
Where DTCP grants planning permission, the local body then issues the building permit. Under rule 10 of the TNCDBR, the authority can ask for more particulars within 15 days and must issue the permission within 45 days of receiving the plan and everything required. Under rule 14, a planning permission or building permit is valid for five years, and the work must be finished within it; it can be extended once, by three years, if you apply before it expires.
What was announced in August 2026. DT Next reported that the state will raise self-certification to 5,000 sq ft, add third-party certification up to 8,070 sq ft, and let corporations and municipalities approve homes up to 16,140 sq ft. As of 17 October 2026, no amendment for this appears on DTCP's state rules page, so the limits above still apply.
After approval, the portal's checklist asks for a commencement notification, a plinth level intimation with photographs of the setbacks, a last storey intimation and the completion certificate. A deviation caught at plinth is a redraw; caught later, it can mean demolition.
Under rule 20 of the TNCDBR, as amended in 2024 by G.O. Ms. No. 69 and G.O. Ms. No. 123, electricity, water and sewerage connections need the completion certificate. Homes up to 14 m with no more than eight dwelling units or 750 sq m are exempt, as are commercial buildings up to 300 sq m and 14 m, and industrial buildings.
It depends on size. The Corporation, or the municipality or panchayat outside city limits, approves homes up to 10,000 sq ft and 12 m. Larger buildings and layouts need DTCP's planning permission first.
Yes. The government approved it on 4 July 2025, and the LPA's 2026 variations amend it. Check your survey number against it, not the 1994 plan.
Yes, by self-certification, if the house meets the limits in step three: plot up to 2,500 sq ft, floor area up to 3,500 sq ft, at most two homes, up to 10 m, outside hill areas and agricultural zones.
Not until the land use allows it. Inside the planning area, you need a government order changing the zone, followed by a gazetted variation. Outside planning areas, the 2017 rules apply, with the Collector's concurrence for wet land.
Approvals go faster with someone who has filed locally before. Browse architects on MOA, see their work and message them directly, with no commission on either side.
