Who approves your Nagpur plot (NMC, NIT, MADC, a council or NMRDA), the Nagpur-only rules inside UDCPR, the plan revision under way, gunthewari plots and NA conversion after the 2025 reform.
Before you rely on any of this: rules, fees and portals change often. This guide was updated in October 2026 for Maharashtra's 2025 land revenue reform. UDCPR clauses below are from the official copy consolidated to 30 January 2025; later changes are notified separately. Confirm the current position with the authority, or an architect who has filed in your area recently, before you spend money. This is a plain-English guide, not legal advice.

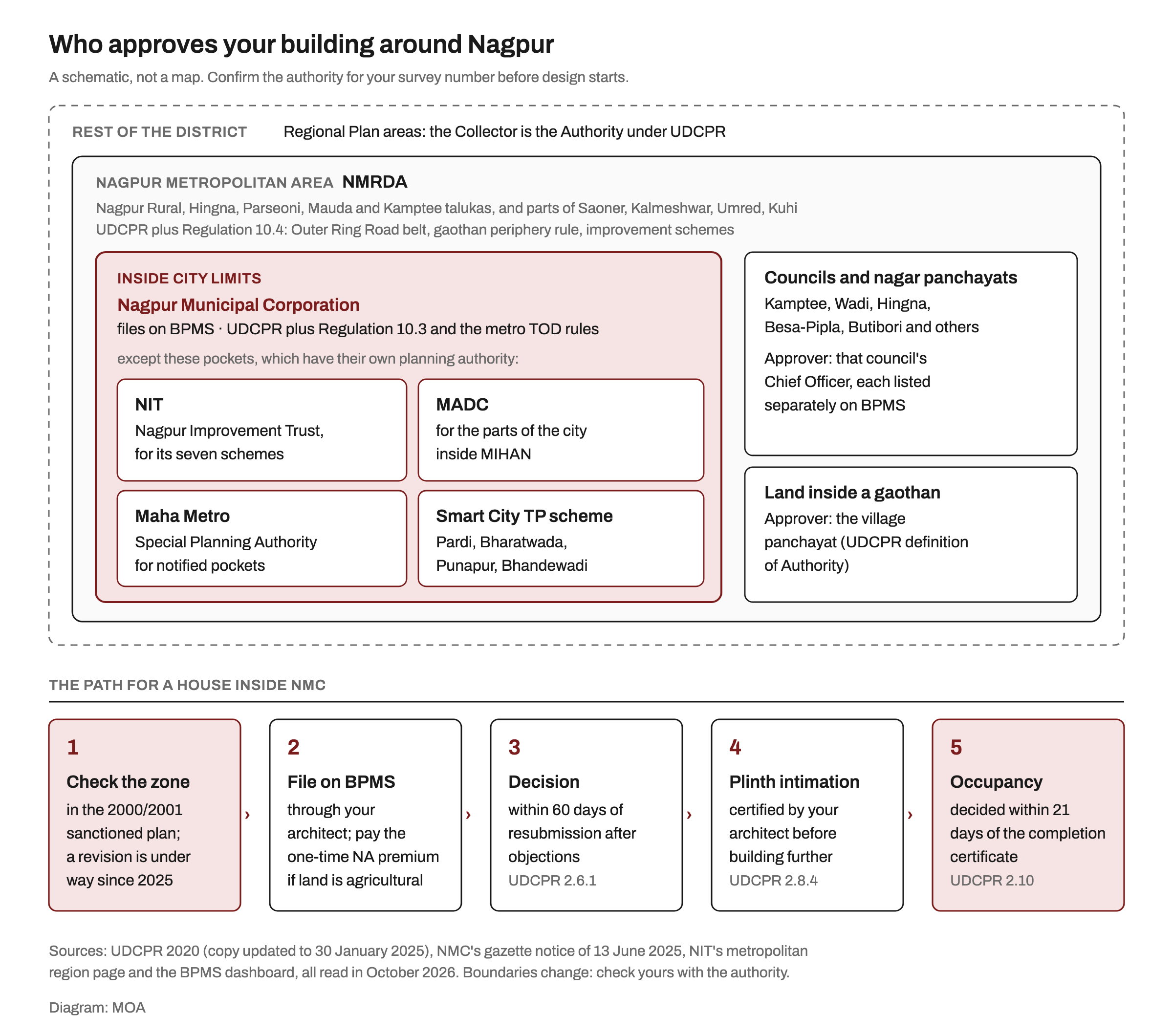

Inside Nagpur city, most building plans are approved by the Nagpur Municipal Corporation (NMC) under the state's Unified Development Control and Promotion Regulations (UDCPR), filed online by your architect on the state's Building Plan Management System. But Nagpur is unusual: even inside city limits, some land has a different planning authority, and the Nagpur Improvement Trust, which the state once decided to dissolve, is still one of them. Outside the city, the Nagpur Metropolitan Region Development Authority (NMRDA) takes over.
If the land is still agricultural on paper, the 2025 reform means no separate NA permission from the Collector where the plan allows housing: the building permission does the conversion.
NMC's own gazette notice of 13 June 2025 sets out the city's history. The Nagpur Improvement Trust (NIT) was set up in 1937 under the Nagpur Improvement Trust Act, 1936, and was the planning authority for the city from 1967. A notification of 9 April 2021 gave NMC planning powers for the whole corporation area except NIT's seven schemes and the Smart City town planning scheme. So inside the city you may meet:
Outside city limits:
If the seller cannot say which applies, treat that as a warning sign. Our plot due diligence checklist covers the other checks to run before you pay.
Many older articles say NIT was dissolved. The record is more tangled:
As of October 2026, NIT's website describes it as a local planning authority under the Urban Development Department, and BPMS lists it separately from NMC and NMRDA. We found no notification dissolving it. If your plot is in or near an NIT scheme, ask NIT and NMC in writing which of them will approve it.
Nagpur follows UDCPR, sanctioned by the State on 2 December 2020. Mumbai's DCPR 2034 does not apply here; our Thane guide explains how UDCPR's approval clock works, and the same clauses apply in Nagpur. Use the latest consolidated copy from the Directorate of Town Planning (currently updated to 30 January 2025). What generic guides miss is the Nagpur-specific text (30 January 2025 copy):
| Rule | What it says for Nagpur |
|---|---|
| Parking (Table 8-C) | NMC's multiplying factor for off-street parking is 0.9, against 1.00 in Pune and Thane. |
| Ancillary FSI premium (Regulation 6.1.1) | 10 per cent of the ready reckoner land rate in Nagpur, against 15 per cent in Pune and Thane. |
| Large residential plots (Regulation 10.3.4) | Plots of 1,000 sq m and above in the residential zone get a basic FSI of 1.25, whatever the road width. |
| Commercial zone (Regulation 10.3.1) | Outside the congested area, basic FSI is 2.00 for residential or mixed use and 2.50 for purely commercial use. |
| Metro corridor (Regulation 14.2.3) | Within 500 m of the Nagpur Metro line, total FSI can rise on payment of premium, from 2.0 on plots under 1,000 sq m on a 9 m road up to 4.0 on plots of 2,000 sq m or more on a 15 m road. TDR cannot be used there. |
| Next to the metro (Regulation 14.2.3) | Within 10 m of the metro, NIT or NMC must get a metro NOC before granting permission. |
| NMRDA area (Regulation 10.4) | A 250 m residential belt along the 60 m Outer Ring Road, on premium; and in rural areas outside the nine urban centres, housing within 750 m of a gaothan (villages up to 5,000 people) or 1,000 m (larger villages), on a premium of 15 per cent of the ready reckoner rate. |
For what setbacks, FSI and height limits mean on an ordinary plot, see our explainer on setbacks, FAR and height limits.
The zoning of your plot comes from the development plan. According to NMC's gazette notice of 13 June 2025 (in Marathi), the city's first plan came into force on 30 July 1976. The first revised plan was sanctioned in part on 7 January 2000, in force from 1 March 2000, and the excluded part on 10 September 2001. That notice declared NMC's intention, under section 23 of the Maharashtra Regional and Town Planning Act, to prepare the second revised plan for the original limits together with a plan for the extended limits, including Hudkeshwar and Narsala, which joined the city in 2013.
A declaration of intention is only the first step: the draft plan, with its zones and reservations, comes later. As of October 2026 we could not find a published draft, so the 2000/2001 plan still governs. Ask your architect to check for any notice published since. In the NMRDA area, the metropolitan plan applies; NMRDA's downloads page lists its notifications of 5 January 2018 and 21 February 2019.
The Maharashtra Land Revenue Code (Second Amendment) Act, 2025 (bill text as published in the Gazette on 8 December 2025, PRS India) rewrote sections 42 and 47 of the Code, and Punekar News reported on 12 February 2026 that a Government Resolution had put it into effect. In short:
Our Pune guide covers the reform in more depth, including land converted earlier. The Nagpur caution is about zoning: in the NMRDA belt much land is in the agriculture zone, where housing is allowed only in limited cases, such as the gaothan periphery rule above. The reform only helps where the plan already permits the use. Read the 7/12 on Mahabhumi for the holder, other rights and occupancy class.
Many plots around Nagpur were sold in unauthorised gunthewari layouts. The Maharashtra Gunthewari Developments (Regularisation, Upgradation and Control) Act, 2001 allows them to be regularised. According to The Hitavada of 9 February 2026, a 2021 amendment covers developments existing on 31 December 2020; NMRDA had about 1.5 lakh applicants but only about 1,000 had received a Regularisation Letter (RL) in three years, largely over a condition that 10 per cent of plots vest in the planning authority; and NMRDA had extended its online deadline to 20 February 2026. NIT runs its own online gunthewari application.
Our guidance, not a rule: if a plot you are buying is in a gunthewari layout, ask to see the RL before you pay, because building permission starts from a regularised plot.
Buying into a promoted project instead? Verify its registration on MahaRERA first.
For most plots inside city limits, the Nagpur Municipal Corporation, through a licensed professional filing on BPMS under UDCPR. NIT approves in its seven schemes, MADC in MIHAN, and NMRDA in the metropolitan area outside the city, except within municipal councils.
No. A dissolution was decided in 2016 and 2019 but reversed in February 2021. As of October 2026 NIT still operates as a planning authority for its schemes and is listed on BPMS.
Not a separate one, if the development plan or Regional Plan permits your use. Since the 2025 amendment, the building permission effects the conversion, with a one-time premium.
Within 500 m of the line, UDCPR allows total FSI up to 4.0 on premium, depending on plot size and road width, but TDR cannot be used there.
Get the plot regularised and the RL issued first, by NIT or NMRDA depending on where it is, and then apply for building permission.
Approvals go faster when the person handling them has filed with your authority before. Browse architects on MOA, see their published work and message them directly, with no commission on either side.
