Who approves your Nashik plot (NMC, NMRDA, a town council or the Collector), the Nashik-only rules in UDCPR, Godavari flood lines, the Kumbh Mela law and NA conversion after the 2025 reform.
Before you rely on any of this: rules, fees and portals change often. This guide was updated in October 2026 for Maharashtra's 2025 land revenue reform and for the Simhastha Kumbh Mela, which opens in Nashik on 31 October 2026. UDCPR clauses are from the official copy consolidated to 30 January 2025. Confirm the current position with the authority, or an architect who has filed in your area recently, before you spend money. This is a plain-English guide, not legal advice.
Inside Nashik city, building plans are approved by the Nashik Municipal Corporation (NMC) under the state's Unified Development Control and Promotion Regulations (UDCPR), filed online by your architect on the state's Building Plan Management System (BPMS). Around the city, the Nashik Metropolitan Region Development Authority (NMRDA) approves in 275 villages, and some towns have their own councils. Nashik also has rules of its own: UDCPR clauses that apply only here, the Godavari's flood lines and a 2025 Kumbh Mela law.
If the land is still agricultural on paper, the 2025 reform means no separate NA permission from the Collector where the plan allows housing: the building permission does the conversion.

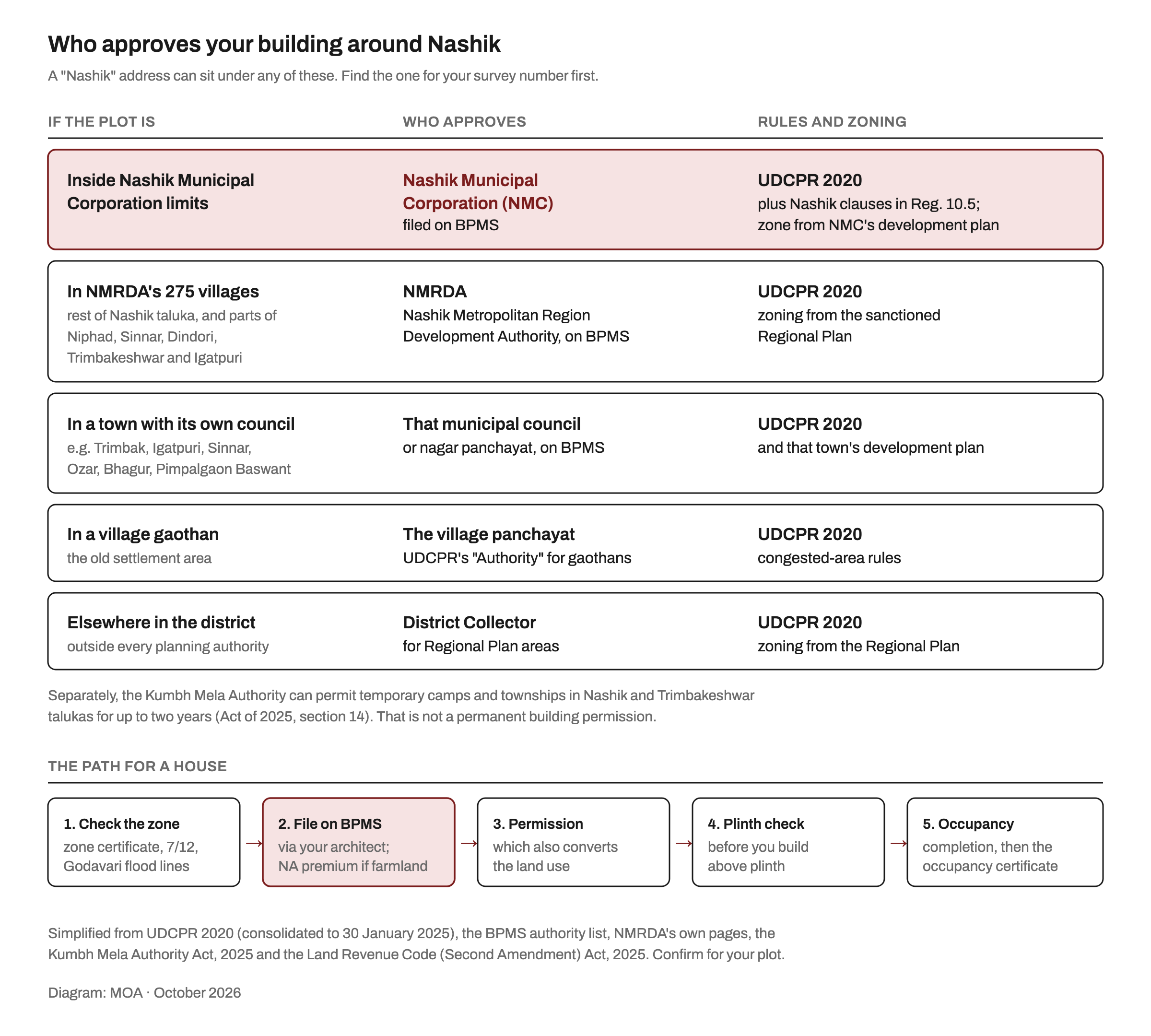

"Nashik" on a listing can mean the city, the taluka or the district. The authorities you may meet:
If the seller cannot say which applies, treat that as a warning sign. Our plot due diligence checklist covers the other checks to run before you pay.
Nashik follows UDCPR, sanctioned by the State on 2 December 2020 and amended many times since. Use the latest consolidated copy from the Directorate of Town Planning (currently updated to 30 January 2025) and ask your architect about anything notified since. If setbacks and FSI are new to you, start with our explainer on setbacks, FAR and height limits.
Where UDCPR treats Nashik differently (30 January 2025 copy):
| Rule | What it says for Nashik |
|---|---|
| Core area (definitions; Regulation 6.1) | UDCPR's "congested area" is called the "core area" in NMC, with its own FSI and margin rules. On a core-area street under 4.5 m wide, the plot boundary moves back to 2.25 m from the street's centre line (Regulation 3.3.5). |
| Nallah cycle track (Regulation 10.5.2) | Along the nallahs shown in UDCPR's Plan A, leave 6 m from the edge of the watercourse. The first 3 m becomes a public cycle track handed over to NMC, with the compound wall built behind it; the owner keeps the strip's FSI and gets TDR or in-situ FSI equal to 35 per cent of its area. |
| Gangapur to Ambad road (Regulation 10.5.3) | On the 36 m DP road from Gangapur to Ambad: plots of at least 300 sq m and 12 m width, a 3 m front setback and 2 m side and rear margins for ground plus two, or stilt plus three, floors. |
| Parking (Table 8-C) | NMC's multiplying factor for off-street parking is 0.9, against 1.00 in Pune and Thane. |
| Ancillary FSI premium (Regulation 6.1.1) | 10 per cent of the ready reckoner land rate in NMC, against 15 per cent in Pune and Thane. |
| Scrutiny fee (Regulation 2.2.12) | ₹5 per sq m of built-up area in NMC and metropolitan authority areas such as NMRDA, against ₹2 in smaller councils and Regional Plan areas, subject to later government orders. |
Near the Godavari, the flood lines can matter more than the zone. Under UDCPR Regulation 3.1.3:
NMC told the National Green Tribunal in a May 2023 affidavit that the Godavari's blue and red lines are prepared by the Irrigation Department, marked on Nashik's development plan from that department's documents, and vary with the river's terrain. Have both lines plotted on your survey before design starts.
The zone and any reservation on your survey number come from NMC's development plan. NMC's Town Planning page carries the revised plan, whose draft was published on 23 May 2015 and modified on 16 November 2015 before going to the State for sanction, according to NMC's notice. NMC refers to it as the sanctioned plan in its 2023 tribunal affidavit. As of October 2026 we could not find an official notice starting the next revision, so check with NMC before relying on press reports of a new plan.
The safest answer for one survey number is a zone certificate, from NMC inside the city or from NMRDA, which promises one in 7 days. Since the 2025 reform accepts a use permitted by the draft or final plan, ask what both say about your land.
The Kumbh opens with flag hoisting at Trimbakeshwar and Ramkund on 31 October 2026 and closes on 24 July 2028, with the main bathing days in August and September 2027, as PTI reported in The Week on 1 June 2025. For owners, two things follow:
The Maharashtra Land Revenue Code (Second Amendment) Act, 2025 (bill text as gazetted on 8 December 2025, PRS India) rewrote sections 42 and 47 of the Code, and Punekar News reported on 12 February 2026 that a Government Resolution had put it into effect. In short:
This matters most in the NMRDA belt, which NMRDA describes as mostly greenfield. Check the land's classification on the 7/12 at Mahabhumi, under the Nashik region, and remember the reform only helps where the zone permits housing. Our Pune guide covers it in more depth. In Regional Plan areas we could not find official guidance on how the premium is collected, so ask the Collector's office before you budget.
Your architect or licensed engineer files the proposal on BPMS; you cannot file it yourself, because the system is built around a licensed professional who signs the drawings. The flow and the UDCPR deadlines (a decision within 60 days of a complete, compliant file, a certified plinth intimation, and the occupancy certificate within 21 days of completion) are the same across Maharashtra, and our Thane guide sets them out clause by clause.
NMRDA publishes its own service times under the Right to Public Service Act: 30 days for building permission, 7 for plinth checking and 30 for the occupancy certificate, each counted after all objections are met. Without an OC, utility connections, resale and home loans all become harder.
Buying into a promoted project instead? Verify its registration on MahaRERA first.
Inside the city, NMC under UDCPR 2020, through a licensed professional filing on BPMS. In the 275 villages around it, NMRDA. Council towns such as Trimbak and Sinnar approve their own, and the Collector approves in Regional Plan areas.
Outside NMC limits in Nashik taluka, yes, unless it is in a gaothan or a council town. In the other five talukas, only if the village is on NMRDA's published list.
Not a separate one, if the draft or final development plan or the Regional Plan permits your use. Since the 2025 amendment, the building permission effects the conversion, with a one-time premium.
Not between the river bank and the blue flood line, except open uses. Between the blue and red lines you can, with the plinth 0.45 m above the red flood line level, under UDCPR Regulation 3.1.3.
Only if it is reserved or acquired for Kumbh works, or used for a temporary township. Ask NMC or NMRDA whether your survey number carries a reservation before you buy.
Approvals go faster with someone who has filed with your authority before. Browse architects on MOA, see their published work and message them directly, with no commission on either side.
